TeardownAugust 6, 20262 min read

"Two Indonesian waste-to-energy projects secured" - award, milestone, or conditional headline?

SUS ENVIRONMENT says it was selected as preferred partner for two Indonesian WtE projects. The announcement contains no capacity, financing, schedule or emissions data - and a Conditional LOA is not a project.

"Two Indonesian waste-to-energy projects secured" - award, milestone, or conditional headline?
01

A preferred-partner announcement is a real event. It is just not the event the headline implies.

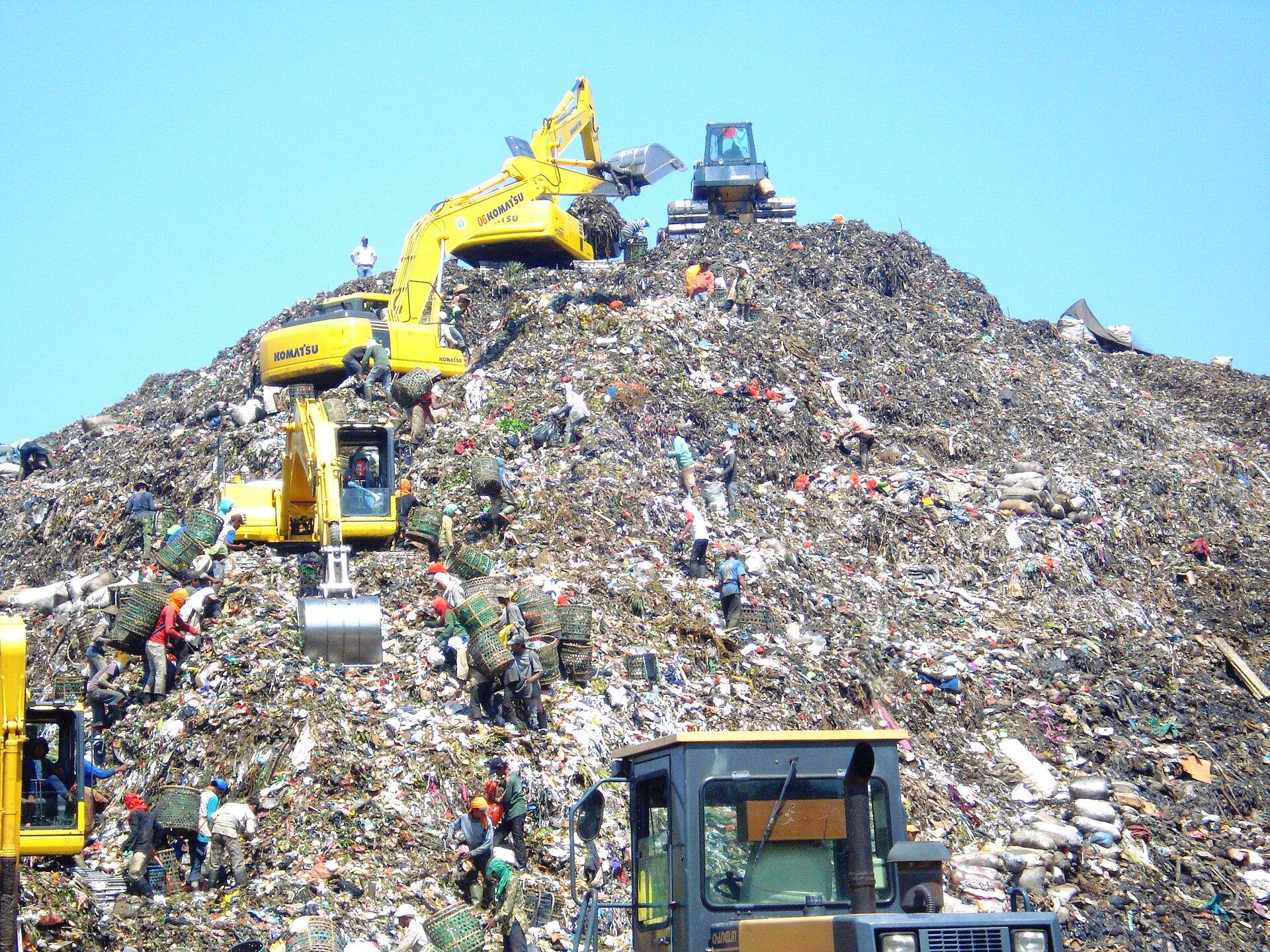

The disposal reality these projects are meant to displace. Whether they do depends on numbers the announcement does not contain.
The disposal reality these projects are meant to displace. Whether they do depends on numbers the announcement does not contain.Photo: 22Kartika, CC BY-SA 3.0, via Wikimedia Commons
02

The claim

68
applications from 85 pre-qualified applicants, per the announcement

SUS ENVIRONMENT announced on 5 August that it had been selected as preferred partner for the Lampung Raya and Surabaya Raya waste-to-energy projects in Indonesia's second selection batch, after a process involving 68 applications from 85 pre-qualified applicants.

SUS says it leads Lampung Raya with PT Indoplas Dewata Energi, and joins the Surabaya Raya consortium with PT Bakrie Power and PT Akritas Karya Persada. The instrument named is a Conditional LOA.

03

What is genuinely strong

Named local partners, in both consortia. That matters in Indonesian infrastructure, where land, permitting and offtake all run through domestic entities.

Some form of competitive screening was passed. And formal WtE capacity, if built, would add both treatment capacity and dispatchable electricity to systems that currently rely heavily on open dumping.

SUS also brings incineration, project-development and operating experience, which is not nothing when the failure mode for WtE in emerging markets is usually execution rather than concept.

04

Where the headline outruns the evidence

The test is not whether a document exists. It is whether the document obliges anyone to spend money.

Here is what the announcement does not state.

Tonnage per day for either project. Electricity output. Construction start. Operations start. Capital cost. Who provides the debt. The tariff. The tipping-fee model.

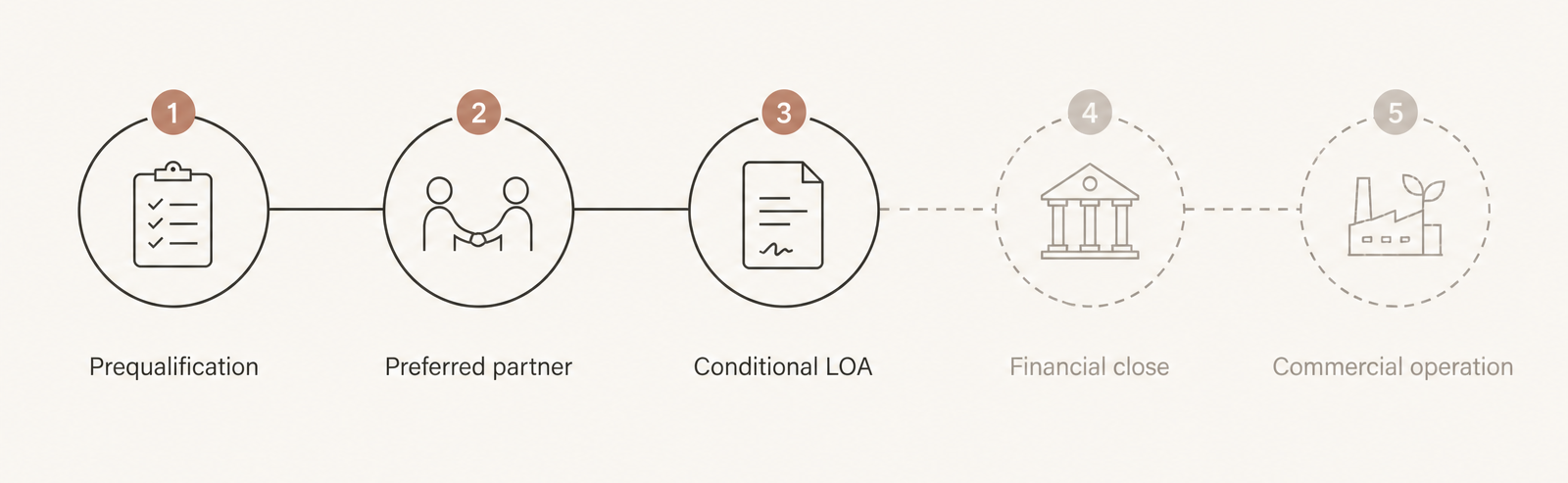

Five distinct stages. The announcement covers the first three. "Secured" belongs to the last two.
Five distinct stages. The announcement covers the first three. "Secured" belongs to the last two.Diagram: The Waste Stack

A preferred-partner designation and a Conditional LOA are not financial close, not construction, and not commercial operation. Every WtE project that ever collapsed also had a signing photo.

05

The program-context check

Danantara Indonesia published a notice the same day describing its reopened DPT process as prequalification only - explicitly not a project award, contract, guarantee of appointment, exclusive right or guarantee of participation. It gives no project site, capacity, investment figure or construction schedule.

That does not disprove SUS's separate second-batch selection; they are different processes. What it does show is why prequalification, conditional selection and bankable project award should never be collapsed into one word.

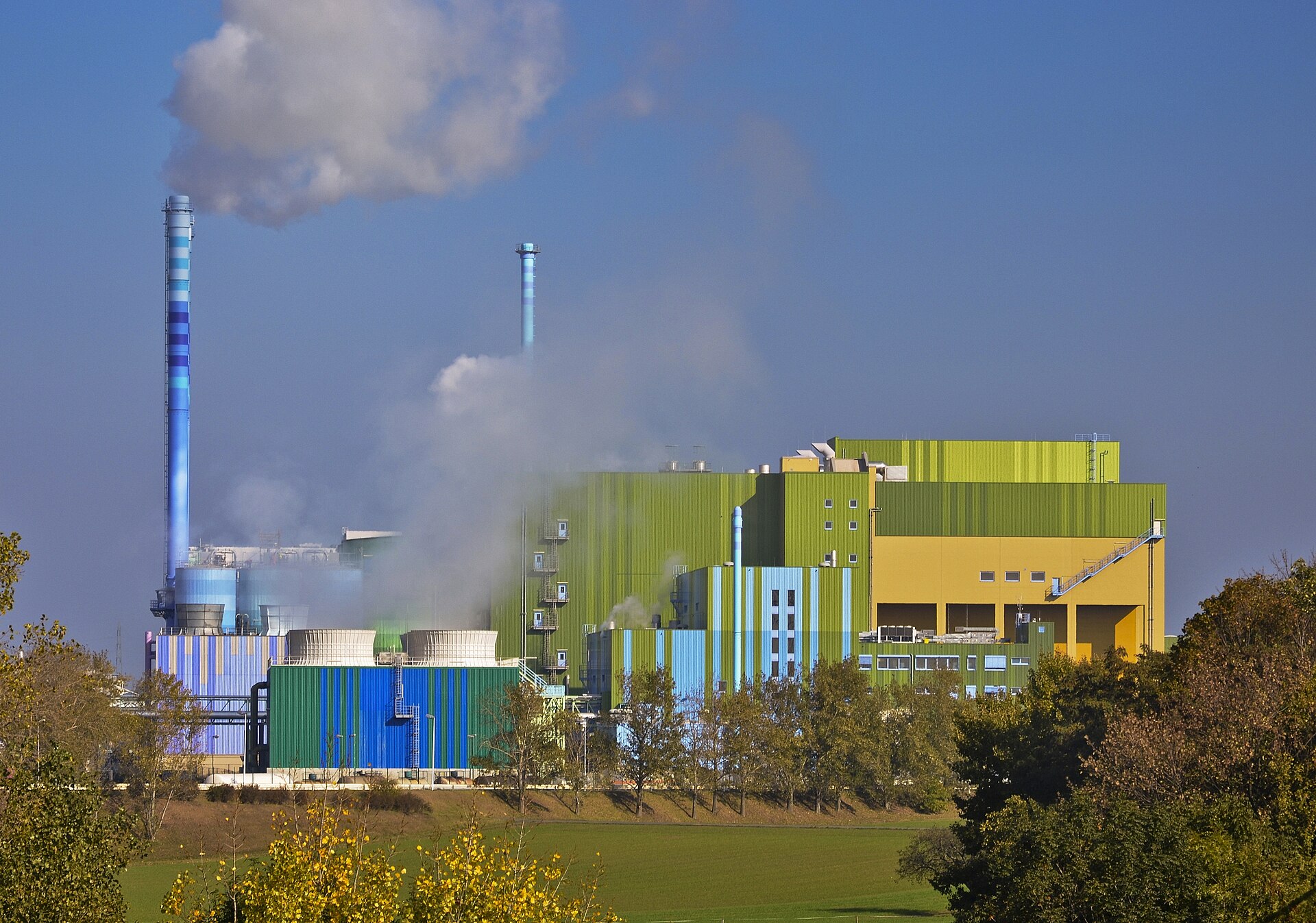

An operating waste-to-energy plant. This is stage five. The announcement is at stage three.
An operating waste-to-energy plant. This is stage five. The announcement is at stage three.Photo: Norbert Nagel, CC BY-SA 3.0, via Wikimedia Commons
06

The circularity and climate questions

0
project-level emissions, ash or feedstock figures in the public announcement

No project-level waste-composition assumptions. No recycling-displacement analysis. No air-emissions control specification. No ash-management plan. No lifecycle carbon accounting. No quantified greenhouse-gas benefit.

These are not nitpicks. Waste composition determines calorific value, which determines whether the plant needs auxiliary fuel. Ash management determines whether you have solved a disposal problem or relocated it. And long-term put-or-pay waste supply contracts are the standard mechanism by which a city ends up penalised for recycling more.

07

The promise

If the selections turn into financed and permitted projects with strong emissions controls and transparent feedstock rules, they expand formal waste treatment, cut uncontrolled disposal, produce reliable electricity, and build local technical capacity. That is a genuinely good outcome and it is achievable.

08

The catch

The business and environmental cases cannot be tested from what has been published. Four questions decide it: do the LOAs become binding agreements, who carries construction and operating risk, is waste supply and power offtake actually secured, and do the long-term combustion contracts end up competing with recycling and organics diversion.

Until those are answered, "secured" is doing work the evidence has not earned.

09

Worth arguing about

What minimum evidence should a WtE developer disclose before "project secured" is a fair headline: capacity, financing, emissions, waste contracts - or all four?
